Gas Main Replacement Project No. 25
Gas-main replacement capital work referenced as Main Replacement Project No. 25.
- Current status
- Ongoing; staff stated there is little flexibility to defer replacement work because targeted PVC pipeline is beyond useful life and targeted steel pipeline has recurring leaks.
- Location

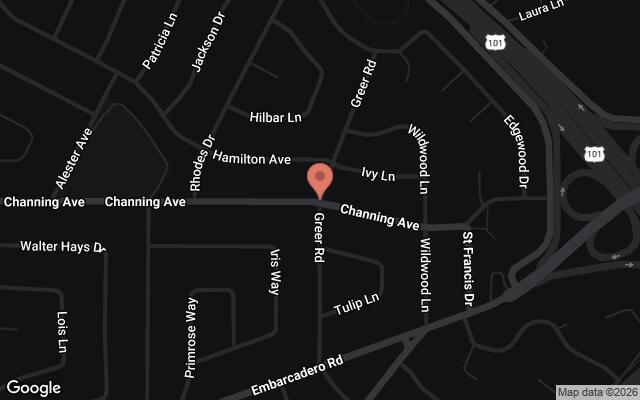

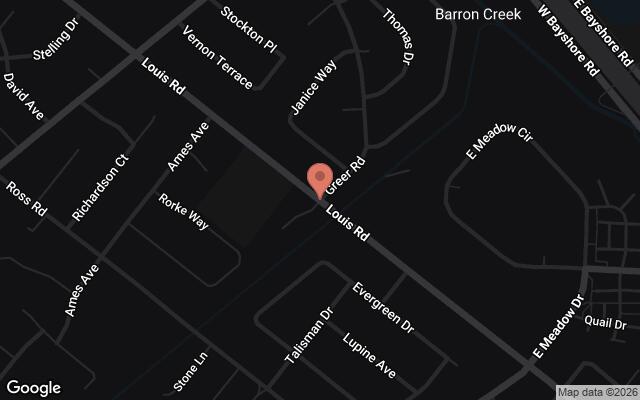

- Duveneck/St. Francis, Leland Manor, Midtown, and Palo Verde neighborhoods
August 5, 2026 update
Crews had installed almost 10,000 linear feet of main and about 220 gas services in the primary residential area.
Read related coverageMarch 31, 2026 gas-main replacement funding and schedule discussion
Staff said GMR 25 is tied to grant funding and had an original $10 million budget; it covers more than 26,000 feet of main and was described as totaling $16.5 million with construction, staff, backfill, and leak-survey equipment costs. Staff said the original GMR 25 budget was split between GMR 26 and GMR 27. Typical $10 million GMR work replaces about 19,000 to 20,000 feet of main.
Read related coverageOctober 20, 2025: Construction contract approval
Council approved Contract C25194217 with Veteran Pipeline Construction for $8,962,204 and authorized change orders up to $896,221.
Read related coverageApril 2, 2025 Update
Staff said the anticipated $16.5 million federal grant would largely fund this gas-main replacement work.
